Project Management Light
- name:
- Project Management Light
- version:
- 1.1.2
- release:
- 2022-10-11
- description:
- Manage your project describing actors and deliverables of your project
- itop-version:
- 2.7.0
- keyword:
- project, deliverable, stakeholder
- dependencies:
- itop-change
- diffusion:
- Client Store, iTop Hub
- state:
- Stable
- php-version-max:
- PHP 8.1
If you need to manage projects for your company but don't want
to invest yet in another tool, this extension will enrich your iTop
with some Project Management capabilities.
This project management follows PMP guidelines. For more
information about PMP : PMI
For even more possibilities, give a look at extended version
Features
This simple version allows already project manager to manage:
-
Projects
-
Deliverables with a Gantt View.
-
Stakeholders involved on project
Project Manager will follow them through a dashboard providing at a glance projects status & costs.
Project Management capabilities can be limited to users needing it.
Revision History
Version | Release Date | Comments |
---|---|---|
1.1.2 | 2022-11-10 | * Add compatibility with iTop 3.1 - remove
deprecated imports * Add compatibility with PHP 8.0 * N°5447 - Deprecate old unreferenced methods that are @deprecated : Object copier * N°5711 - Wrong title for “Open project, I'm involved in” list in displaybare relations “Projects & deliverables” on contact provided by PMP |
1.1.1 | 2022-02-17 | Keep person and contact customization when installing PMP |
1.1.0 | 2022-02-15 | Compatibility with iTop 3.0 Remove deprecated function AddObject and GetExpectedAttributes Fix redesign issue of presentation screen of Person and Contact class Add view of all stakeholders on Summary tab (project's ones, deliverables's one, project manager and sponsor Add project_completion field on Project class based on average of deliverables completion |
1.0.5 | 2020-11-04 | Fix installation issue |
1.0.4 | 2020-10-20 | Update DisplayBare calculations Resolve issue on stimuli that Project manager could not see Add method to duplicate project through object-copier Increase project manager's id to avoid conflict with customers datamodel |
1.0.0 | 2017-06-27 | First version |
Limitations
-
At deliverable creation, we can just add parent deliverable (we hide child deliverable). We prevent modification of child deliverable, we can update parent deliverable only.
Requirements
Requires at least iTop 2.7 for Gantt View.
Installation
Use the Standard installation process for this extension.
Configuration
The extension is adding, at installation time, entries to the list of rules defined for the User actions configurator extension if you have this extension installed. Deliverable can be created from Project object within status other than “closed” or “monitored” and you can duplicate project (with all its objects linked like deliverables, contacts).
array ( 'source_scope' => 'SELECT Project WHERE status NOT IN (\'closed\',\'monitored\',\'cancelled\')', 'allowed_profiles' => 'Project Manager,Administrator', 'menu_label' => 'Créer un délivrable...', 'form_label' => 'Créer un délivrable pour %1$s', 'report_label' => 'Créée depuis %1$s', 'dest_class' => 'WBS', 'preset' => array ( 0 => 'copy(id,project_id)', 1 => 'set(start_date,$current_date$ $current_time$)', 2 => 'copy(agent_id,wbs_owner_id)', ), 'retrofit' => array ( ), ), array ( 'id' => 'CopyProjectExt', 'source_scope' => 'SELECT Project WHERE status NOT IN (\'closed\',\'monitored\')', 'allowed_profiles' => 'Project Manager,Administrator', 'menu_label' => 'Class:Project/DuplicateProject', 'form_label' => 'Class:Project/DuplicateProjectForm', 'report_label' => 'Créée depuis %1$s', 'dest_class' => 'Project', 'preset' => array ( 0 => 'clone_scalars(*)', 1 => 'clone(contacts_list,functionalcis_list)', 2 => 'call_method(Copydeliverablestodeliverables)', ), 'retrofit' => array ( ), ),
-
This extension brings a new profile named Project Manager
Usage
After installation, you will see Project Management group Menu as below
As Project Manager, you will
-
create a project describing its goal, its scope, its constraints and its actors.
-
then, you will start to divide your overall project on small deliverables.
-
For each deliverable, you will assign a deliver owner who will define planning, costs, stakeholders.
Thanks to this work, you will have a more precise idea of costs and planning for your overall project.
New Project
Project properties

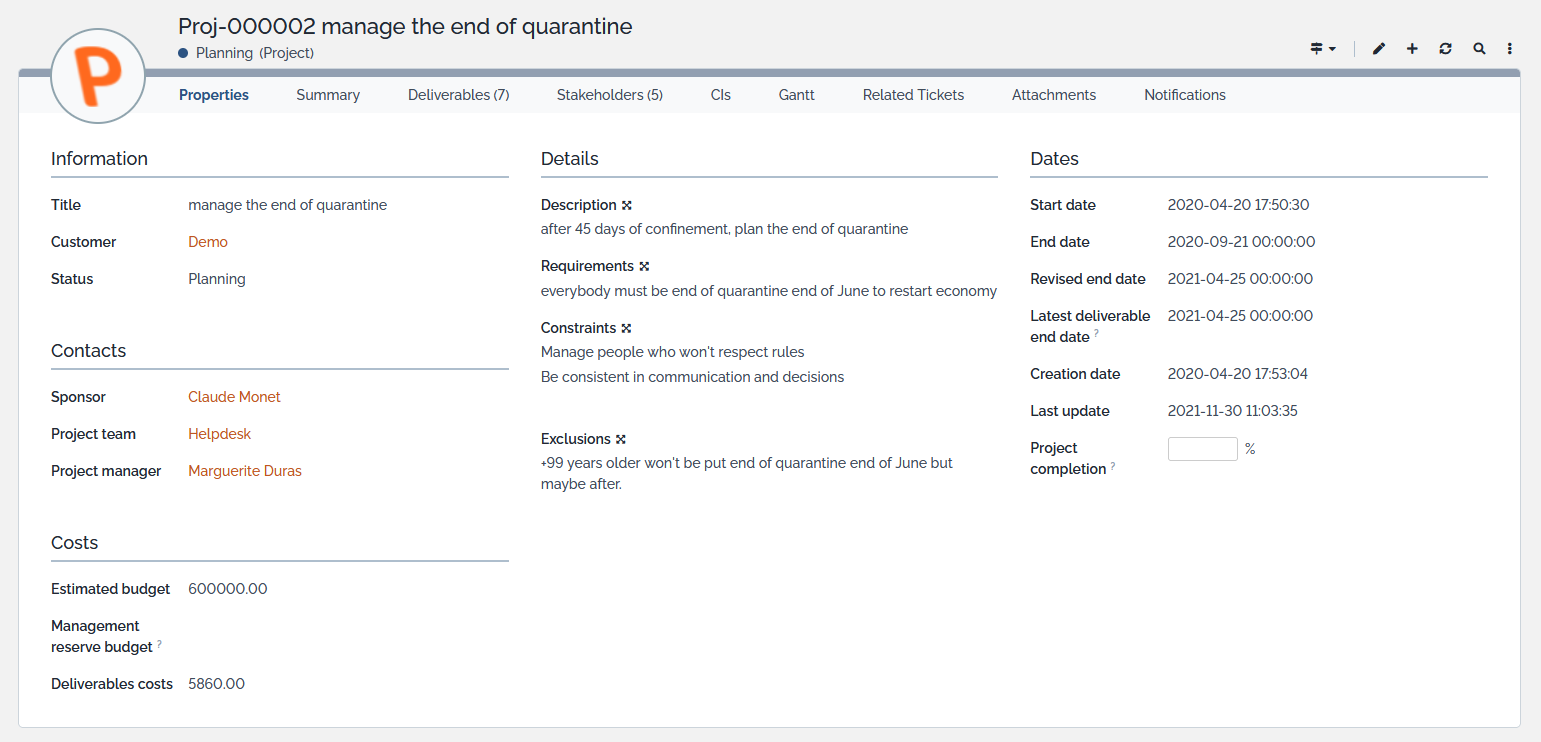

A Project has the following attributes:
Field | Type | Comment | Mandatory ? |
---|---|---|---|
Project Name | Alphanumeric string | Yes | |
Project for Customer | Foreign key to an Organization | Project is related to an organization | Yes |
Status | EnumList | Possible values: Initiating, Planning, Executing, Monitoring, Closing | Yes |
Project Description | Text(HTML) | description of project | No |
Project Requirements | Text(HTML) | What is absolutely required to be done for this project | No |
Project Constraints | Text(HTML) | Describe constraints that project will have to consider | No |
Project Exclusions | Text(HTML) | Describe what is out of scope of your project | No |
Project Sponsor | Foreign key to a Person | Authorizes the project | No |
Project Manager | Foreign key to a Person | Executes the project | No |
Estimated budget | Decimal | Amount of your budget to execute project | No |
Management reserve budget | Decimal | Financial reserve of Sponsor to manage escalations | No |
Deliverables costs | Decimal | Costs of all deliverables attached to this project (calculated) | Read-only |
Project start date | Date (year-month-day ) | Enter Start date of your project | Yes |
Project end date | Date (year-month-day ) | Enter planned end date of your project. This one can't be before start date | Yes |
Revised end date | Date (year-month-day ) | Enter revised end date of your project in case of rebaseline. This one can't be before latest date of deliverable end date. if no date is entered, latest end date of deliverable is copied | No |
Latest deliverable end date | Date (year-month-day ) | Consider the latest deliverable's end date attached to this project | Read-only |
Creation date | Date (year-month-day ) | creation date of Project's ticket | Read-only |
Last Update | Date (year-month-day ) | last update date of Project's ticket | Read-only |
Project completion | Percentage | Average of completion of all deliverables attached to project (Each deliverable weighted by time planed versus % of completion) (on 1.1.0 version) | Read-only |
Tabs
Tab | Description |
---|---|
Summary | Calculated Summary in one page of your project |
Deliverables | All the deliverables belonging to this project |
Stakeholders | All the contacts linked to this project with their interest, power, allocation in % and allocation in days |
CI | All the CIs linked to this project, if applicable |
Gantt | Gantt View of all deliverables attached to this project |
Attachments | Documents related to this project |
Project lifecyle
Project Summary

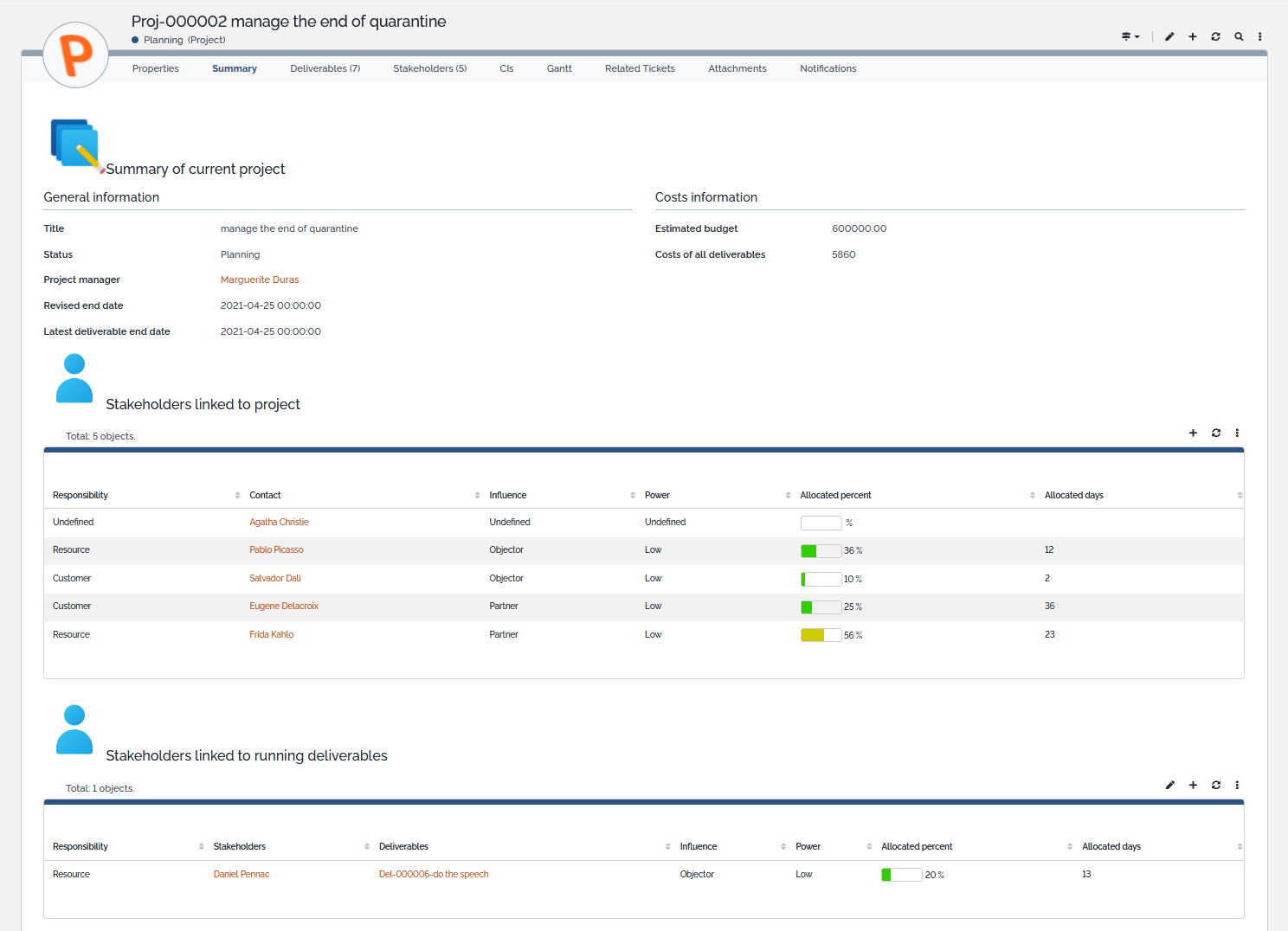

A calculated tab “Summary Project” is displayed near to properties tab. On this tab, you will find consolidated view:
-
Project dates information
-
Sum of all deliverables costs (even completed ones)
-
list of involved people (either directly on project level or on deliverable level)
-
list of opened deliverables
-

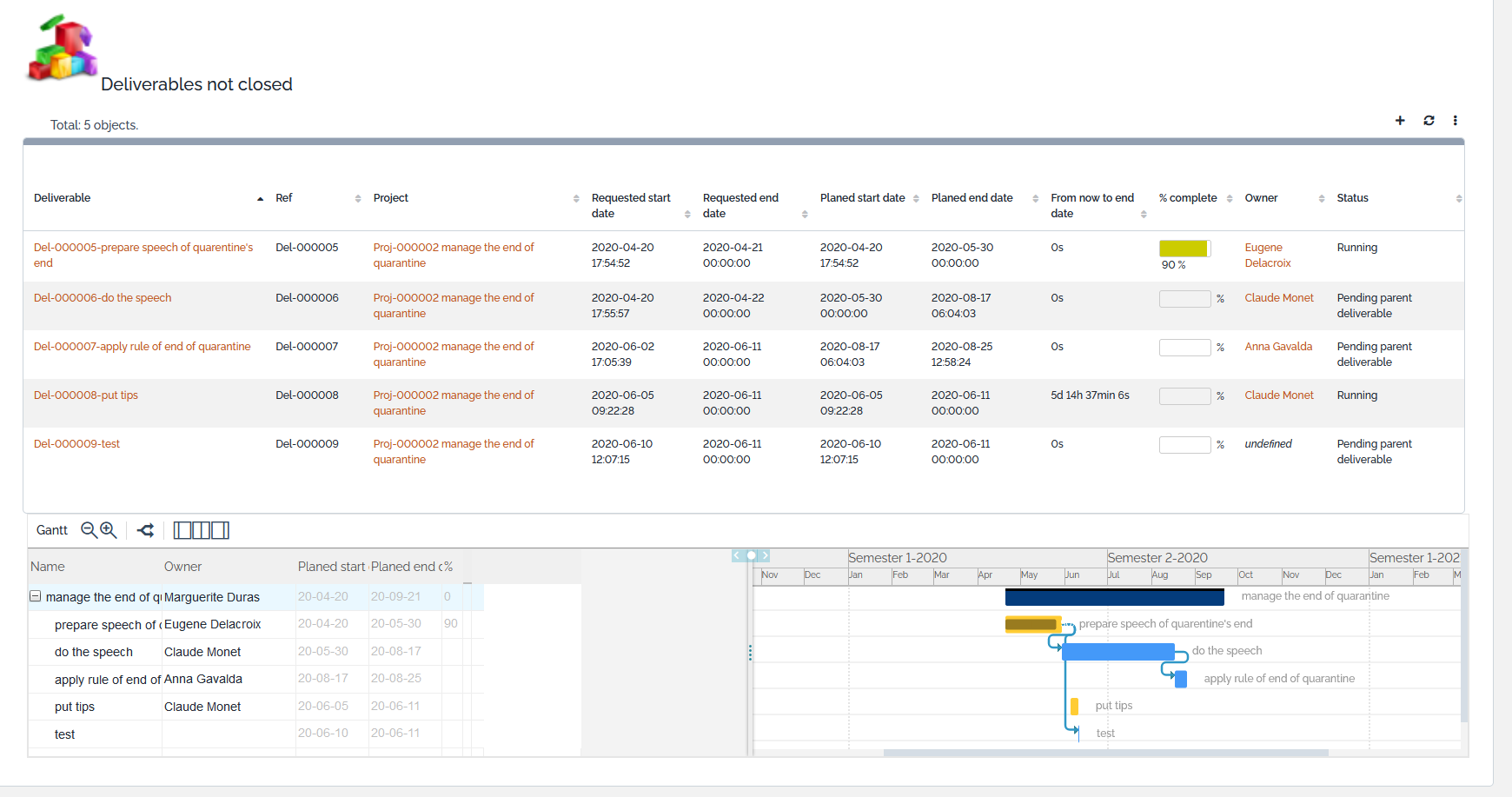

Gantt View of project's deliverables

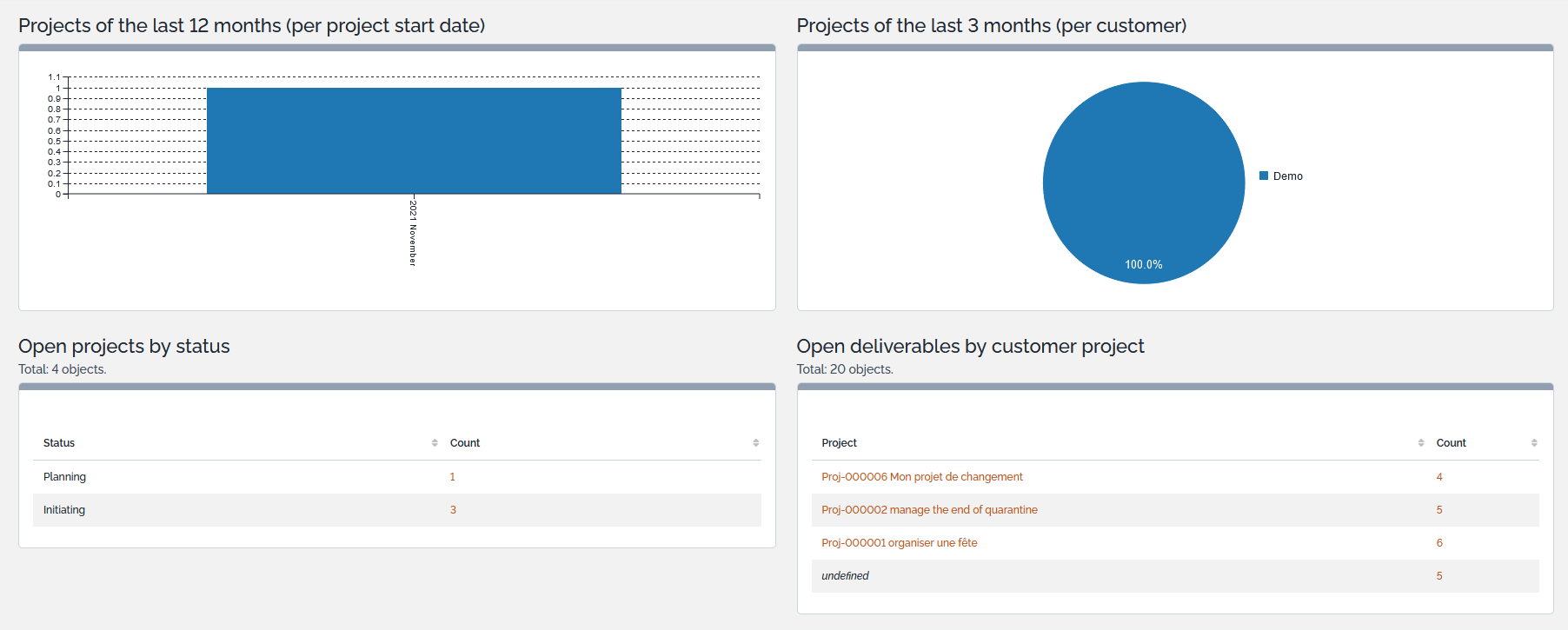

Project Dashboard
Under Project Management Menu, you have dashboard that will present open project, deliverables.
Project Stakeholders
In this tab, you will link all actors of project (customers or doers). You can define for each of them their
Role | Possible values: Customer, Resource |
Influence | Possible values: Partner, Objector |
Influence Power | Possible values: Low, Strong |
% Allocation | provide a % of time resource or customer is allocated on project |
Day allocation | provide number of days a resource or a customer is allocated on project |
This information will describe how you must manage and communicate with these stakeholders and plan the load of your resources.
Deliverables
To deliver medium to big project, you will split it in several deliverables which may have dependency between each others. Each deliverable will have costs, start date, end date and may be dependent between each others. In that case, you will declare parent deliverable.
Deliverable properties
Deliverable has following attributes
Field | Type | Comment | Mandatory ? |
---|---|---|---|
Deliverable Name | Alphanumeric string | Name of deliverable | Yes |
Project name | Foreign key to a Project | Deliverable is linked to a project (directly or not)) | Yes |
Deliverable owner | Foreign key to a Person | Person who will execute the deliverable | No |
Status | EnumList | Possible values: Running, Pending parent deliverable, Cancelled, Completed | No |
Description of work | Text(HTML) | Describe the deliverable | No |
Acceptance criteria | Text(HTML) | Describe the Acceptance criteria for resolution of deliverable | No |
Technical information | Text(HTML) | Describe technical steps of the deliverable | No |
Deliverable Budget | Decimal | Total budget to execute this deliverable | No |
Labor cost | Decimal | Human and Software costs | No |
Material cost | Decimal | Hardware costs | No |
Deliverable Total cost | Decimal | Automatic sum of Labor and Material costs | Read-only |
Available budget | Decimal | Amount of available budget (Deliverable Budget -Deliverable Total cost). Calculated on creation or update of deliverable | Read-only |
Time planned | Duration | Effective time required for deliverable's execution | No |
% Complete | Percentage | % of completion of deliverable | No |
Requested start date | Date (year-month-day ) | initial requested start date of deliverable | Yes |
Requested end date | Date (year-month-day ) | initial requested end date of deliverable | Yes |
Planned start date | Date (year-month-day ) | Reviewed start date of deliverable - Can't be before end date of parent deliverable. if you put a start date before parent's end date, it will automatically postpone child's “Planned start date” when you save ticket. | No |
Planned end date | Date (year-month-day ) | Reviewed end date of deliverable. If “Planned start date” has been postponed, “Planned end date” will be automatically postponed, as well, including intial delay between start and end date. | No |
from Now to end date | Duration | Remaining time between now and re-estimated end date | Read-only |
Until iTop 2.7.1, you will have as such messages as deliverables updated. For example, you create new deliverable with an owner not defined in project as stakeholder, your end date's deliverable impacts 3 others already existing deliverables so you will receive 4 times warning message.
Deliverable automatic calculations
As soon as you update some attributes on deliverable, automatic calculations will run:
-
if costs have been updated, “Deliverable Total cost” and “Available budget” will be recalculated
-
if planned start or end date is updated, then all child deliverable's dates will be recalculated.
Tabs
Tab | Description |
---|---|
Child Deliverable | Child deliverable - Child can't start before current deliverable's end date |
Parent Deliverable | Parent deliverable - current deliverable's can't start before end date of parents attached |
Stakeholders involved | All the contacts linked to this deliverable with their interest, power, allocation in % and allocation in days |
Deliverable Stakeholders
In this tab, you will link all actors of project (customers or doers). You can define for each of them their
Role | Possible values: Customer, Resource |
Influence | Possible values: Partner, Objector |
Influence Power | Possible values: Low, Strong |
% Allocation | provide a % of time resource or customer is allocated on project |
Day allocation | provide number of days a resource or a customer is allocated on project |
This information will describe how you must manage and communicate with these stakeholders and plan the load of your resources.

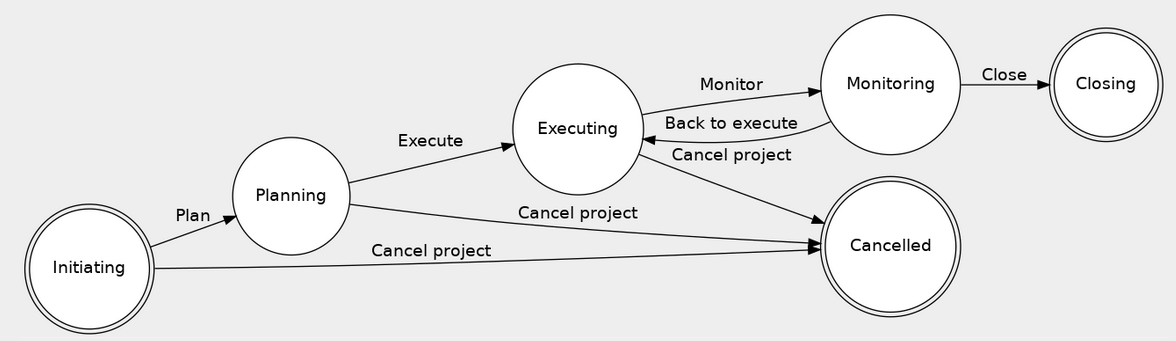

Deliverable lifecyle
As soon as deliverable has a parent, it will be created in status “pending parent deliverable” and will be re-activated in “running” statuts, automatically, as soon as parent deliverable is “completed”.
Gantt View
In Gantt tab , you will see graphically all deliverables of your project.
In green, you will have the closed deliverables, in blue all running deliverables.
Stakeholder view from Contact Class
As soon as an iTop contact is involved on a project or on a deliverable, you will see appearing tab “Project& deliverable”. This calculated tab will display all projects and deliverable, the contact is involved on.
